Capacity Planning Process for your Professional Services Organization
Objectives
Align resource supply with both committed (signed) and forecasted (pipeline) demand.
Identify skills gaps and proactively staff or hire to fulfill upcoming projects.
Maintain a healthy backlog of 3–6 months of work to support revenue stability and operational predictability.
Why Capacity Planning Matters
Professional Services organizations operate at the intersection of people, projects, and customer commitments. A capacity planning process allows your team to make smarter decisions about staffing, hiring, project timing, and resource utilization.
This guide outlines how your organization can:
Gain visibility into all current and potential work
Match supply (your team’s skills and hours) with demand (your active and upcoming projects)
Identify potential overutilization or resource shortages before they become issues
Create a 3–6 month healthy backlog of work to ensure consistent delivery and revenue
Ensure customer projects are staffed with the right talent at the right time
Whether you're planning for a sudden influx of project work or looking to scale your services delivery team, a strong capacity planning process is foundational to delivering excellence to your customers — on time, with confidence, and with the right people.
Step-by-Step Capacity Planning Framework
1. Define Capacity Planning Time Horizons
Capacity planning involves forecasting resource needs over various future periods. Categorizing the planning into time horizons allows organizations to prepare with the appropriate level of confidence and action.
Capacity Timeline Horizons
Each horizon requires different levels of commitment: signed projects in the short-term demand immediate attention; mid-term projects need readiness; long-term helps anticipate hiring or strategic direction.
2. Consolidate Demand Data: Signed & Pipeline Work
a. Active Signed Projects
This is the most concrete form of work to plan for. Projects that are under contract should have clear start and end dates, agreed scopes, and defined resource needs.
Pull data from your PSA (Professional Services Automation) tool or tracker.
For each project, collect:
Start and end dates
Roles needed (e.g., project manager, consultant)
Hours or FTEs required per role
Specific skill requirements (tools, industries, certifications)
b. Sales Pipeline Projects
Pipeline projects are potential deals still in the sales cycle. Incorporating them helps forecast future demand but requires probabilistic planning.
Extract data from CRM tools (e.g., Salesforce) or sales forecasts.
Classify opportunities by sales stage:
Stage 1–2: Early forecast (low likelihood)
Stage 3–4: Weighted forecast (moderate likelihood)
Stage 5+: Committed forecast (high likelihood)
Apply a probability factor to each opportunity’s resource estimate (e.g., 50% of hours if in Stage 3).
Output:
Consolidated Project Demand Model (signed + weighted pipeline)
3. Inventory Resource Supply
Assess your current delivery team’s availability and capabilities.
List all billable team members
Record standard weekly billable hours (e.g., 32–36 hrs/week)
Track time-off, leave, or training
Maintain a skills matrix:
Products/tools (e.g., Salesforce, NetSuite)
Industry experience
Certifications or domain expertise
Use a resource management tool or spreadsheet to track this monthly.
Output:
Resource Supply Model (by person, role, and skill)
4. Build a Capacity vs. Demand Model
Overlay resource supply with demand to identify gaps or surpluses.
Compare demand (from signed and pipeline projects) with available resource supply
Break it down by:
Role (e.g., Solution Architect, Functional Consultant)
Skill (e.g., AI expertise, platform configuration)
Time period (weekly or monthly)
Key Metrics:
Utilization Forecast: % of total available hours committed to work
Backlog Coverage Ratio: Forecasted hours ÷ Monthly delivery capacity
Skill Gaps: Forecasted demand that lacks matching available supply
Visualization Tools:
Heatmaps to show over/under-capacity
Stacked bar charts (capacity vs. demand over time)
Burn-down projections for backlog
Output:
Capacity vs. Demand Dashboard
5. Conduct Monthly Capacity Planning Meetings
Establish a cadence where leadership reviews current and upcoming capacity realities.
Participants:
PS Delivery leadership
Resource manager or operations lead
Sales lead
Practice or department leads
Discussion Topics:
Confirm status of signed project resource assignments
Evaluate pipeline probability and timing
Identify projected shortfalls or excess capacity
Discuss hiring needs or internal training requirements
Align on use of partner resources or freelancers
Output:
30-60-90 day staffing plan
Hiring and recruitment updates
Deal pacing feedback to Sales
6. Build an Early Warning System
Establish indicators that alert the team to potential issues in advance.

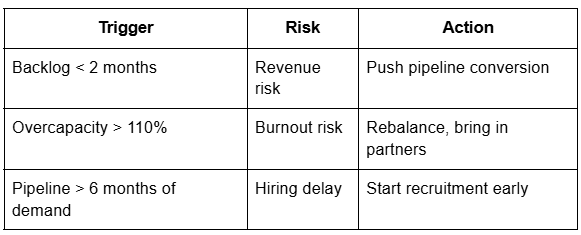

Warning System Triggers
This helps the organization remain proactive, not reactive.
Output:
Capacity Planning Risk Tracker (reviewed monthly)
Best Practices
Separate roles from skills: One individual may cover multiple functions; skills should align with the work, not just titles.
Forecast with confidence levels: Staff only what’s highly probable; leave flexibility for lower-stage deals.
Rolling 12-month forecast: Encourages long-term hiring, bench building, and development planning.
Cross-functional collaboration: Sales and delivery must communicate weekly.
